We are so excited to have launched 'Unfinished', and to have shared our architect's design, as we look forward to seeing our building revitalised in this new season here at The Bridge Church.
You'll see here our Visual Snapshot of our 'Unfinished' Project. Below you'll find some of our FAQs for our 'Unfinished' project.
What is our budget?
Total Project Estimated $1.2M (not yet verified)
STAGE 1: $700K (estimated)
STAGE 2: $500K (estimated)
How will we fund ‘Unfinished’?
- Approximately half of our project will be funded from proceeds of our Church Investment Property in Napier St, Williamstown. To complete the project, we are inviting the Church to give towards the remainder of the project costs.
- Your gift or pledge on ‘Unfinished’ Giving Sundays 13 April, 4 & 11 May 2025

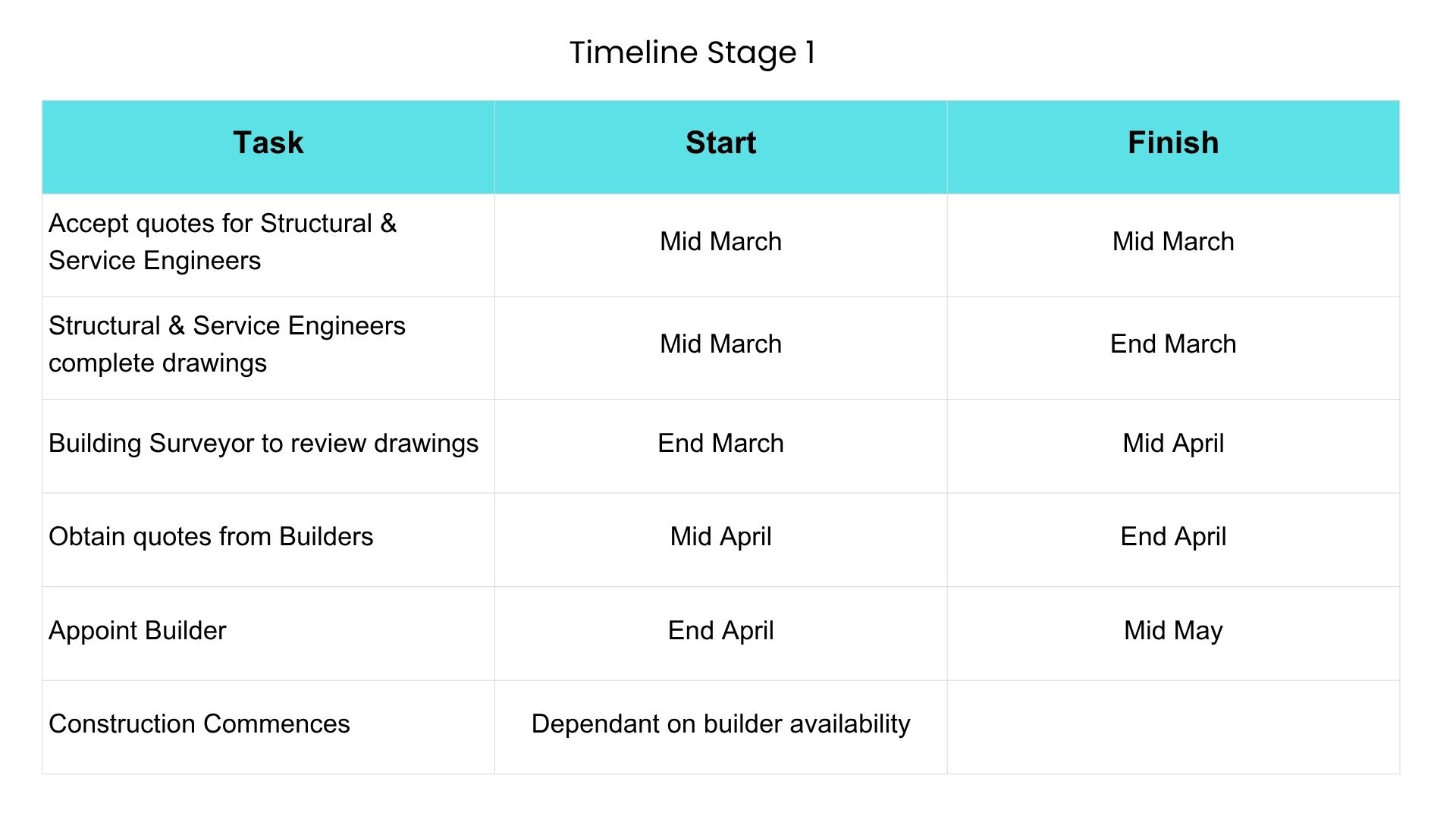

What is our Project Timeline?
- ‘Unfinished’ Series - March to May 2025
- Planning Permit Phase - June to September 2025
- Building Permit Phase - September 2025 to April 2026
- Commencement of Stage 1 Construction - April 2026
How Can You Be Involved?
- Pray for the project - prayer is powerful!
- Give – or begin your giving journey:
~ Give or pledge on ‘Unfinished’ Giving Sundays 13 April, 4 & 11 May 2025
~ Give regularly in tithes and offerings
Keep an eye on our socials, for some more story sharing on 'Unfinished'.
